Norwalk Bridge Transmission Relocation Project

en Español

Why Are We Doing This Project?

Connecticut Department of Transportation (CDOT) is currently rebuilding the Walk Bridge (railroad bridge) that crosses the Norwalk River to ensure continued railroad operation along the vital Northeast rail corridor.

As part of this work, we must relocate and energize the two electric transmission lines that span the top of the bridge.

This work is necessary to help keep the power flowing in Norwalk.

Where Is The Work Being Done?

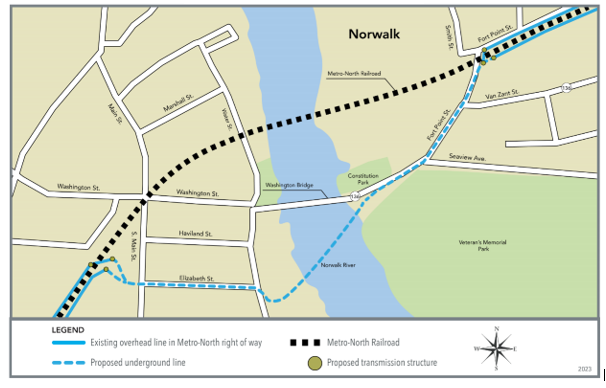

Norwalk-Bridge-Map

We have worked closely with Norwalk officials, CDOT and other stakeholders since 2016 to develop a route that meets all required electrical reliability standards, limits environmental and community impacts, and can be built at a reasonable cost. Several potential routes for the relocation of the lines were reviewed.

The project route includes transitioning the two existing overhead transmission lines to underground near the Norwalk Police Department. The lines will continue beneath the police station parking lot and down Elizabeth Street, to an area off Water Street.

From Water Street, the lines will be placed beneath the Norwalk River via horizontal directional drilling (HDD) to an area on Fort Point Street near the entrance of Veteran’s Memorial Park.

The lines will continue beneath Fort Point Street where they will reconnect to the overhead lines along the railroad corridor in the vicinity of the Fort Point Street bridge.

To facilitate transitioning the overhead lines to underground, new steel monopole structures will be installed near the railroad corridor in the vicinity of the Norwalk Police Station and the Fort Point Street bridge.

When Is The Work Being Done?

  • CSC petition approval: May 26, 2023 (see filing PE1560)
  • File environmental permits with CT DEEP: June 2023
  • Advanced utility work: Completed as of November 2023
  • Begin transmission line construction: March 2024
  • Complete construction: Third quarter 2025
  • Complete restoration: By the end of 2025

About this project

  • Route length: Approximately 0.75 miles
  • Line voltage: 115,000 volt (115-kV) underground transmission lines
  • Siting review: Connecticut Siting Council
  • Environmental permitting: Connecticut Department of Energy & Environmental Protection (CT DEEP) and U.S. Army Corps of Engineers

Construction Updates

Overhead Line Construction

The installation of a new concrete foundation and associated street repairs near the Fort Point Street railroad bridge was completed in early April 2025. Construction activity to install a new steel monopole structure that will support the overhead electric lines is expected to begin in late May.

Underground Line Construction

Construction for the new underground lines began in April 2024. The underground line work and cable installation was completed in March 2025.

Horizontal Directional Drilling (HDD)

Horizontal directional drilling beneath the Norwalk River and boat launch parking lot at Veteran’s Memorial Park was completed in January 2025.

Week of April 21

90 Water Street

Construction activities will continue at 90 Water Street. Typical work hours are 7 a.m. to 7 p.m., Monday through Saturday.
